Goldman Sachs did not upgrade AMD in May 2026 on a thin story. The firm moved AMD to Buy, doubled its price target to $450, and did so after AMD reported Q1 revenue of $10.25 billion against estimates of $9.9 billion. Data center revenue reached $5.78 billion, up 57% year over year. Bernstein followed with an Outperform rating and a $525 target, arguing that agentic AI would become a structural tailwind for server CPUs, not just for accelerators.[1]
That is a credible starting point for reading AMD’s upgrade through the supply chain. The revenue print says demand is already showing up. Bernstein’s CPU thesis also has a real infrastructure logic: if agentic AI systems create more autonomous workflows, planning loops, retrieval steps, and tool calls, they do not consume only GPU cycles. They also put pressure on general-purpose server compute. ChainSignal has covered that operational shift in agentic AI supply chain use cases, where the important distinction is not whether the phrase is fashionable, but which workloads actually move into production.
The harder question is what portion of that demand AMD can physically turn into shipments. An upgrade can be right about customer appetite and still be too clean about the path from order book to revenue. In 2026, AMD’s most interesting supply-chain signal is not simply that EPYC CPUs and AI GPUs are both strong. It is that both are pressing into the same scarce advanced-packaging channel.

The Upgrade Depends On What Can Be Packaged

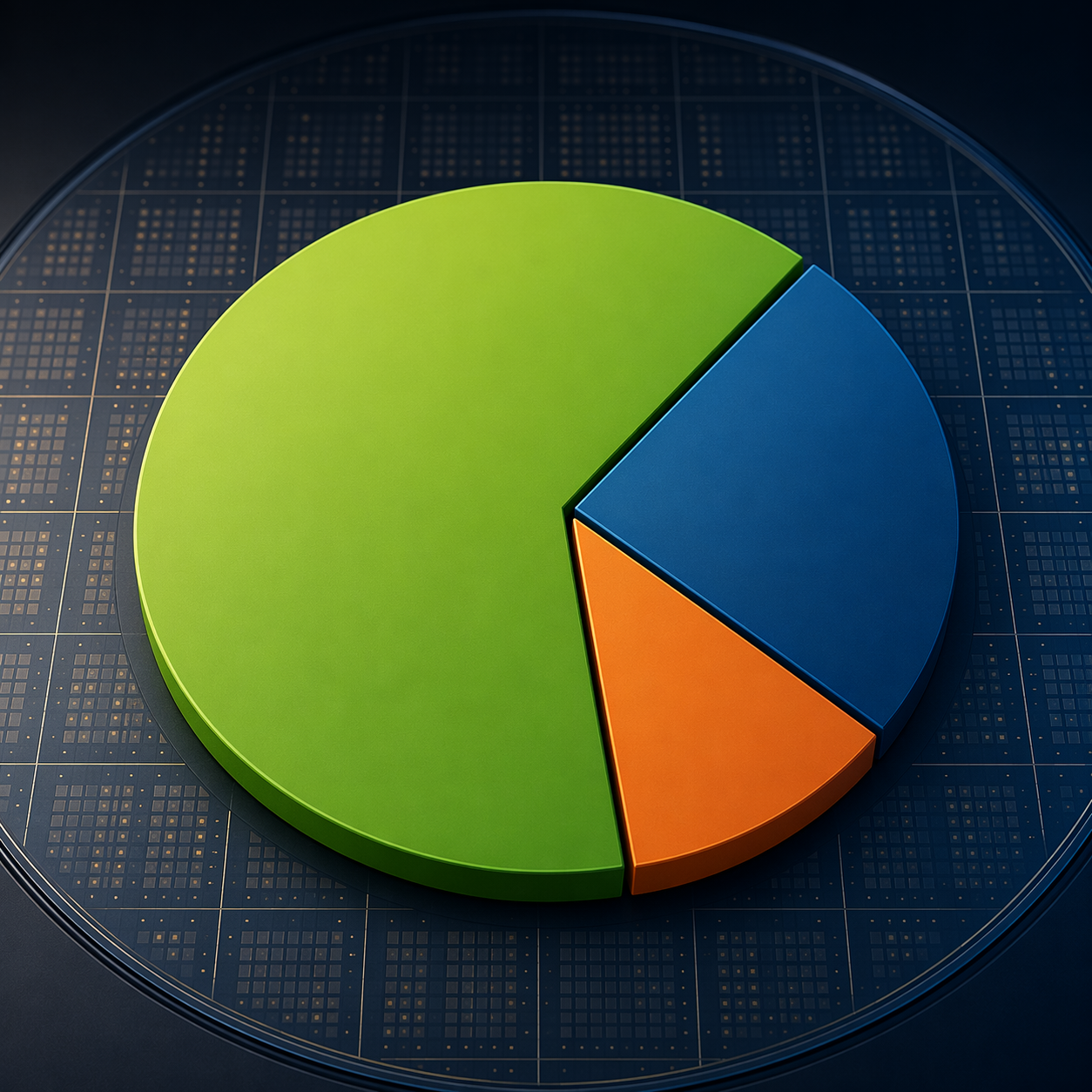

The bottleneck is CoWoS, TSMC’s advanced-packaging technology used to assemble high-performance chips with memory and interconnect density that conventional packaging cannot provide. Silicon Analysts’ Q1 2026 foundry allocation work describes CoWoS as sold out, with reported lead times of 52 to 78 weeks. It also estimates that Nvidia holds roughly 60% of capacity, or about 595,000 wafers, while AMD holds roughly 11%, or about 105,000 wafers.[2]
Those AMD allocation numbers should be handled as informed estimates, not confirmed procurement data. Silicon Analysts flags per-customer wafer counts as lower-confidence and contested across industry sources. Still, the direction is useful: CoWoS is concentrated, tight, and dominated by a few buyers. The same source estimates that Nvidia, Broadcom, and AMD together account for more than 85% of total CoWoS capacity.[2]

That concentration changes how the AMD upgrade should be read. A revenue model can assume a higher mix of data center products. A procurement team has to ask whether those products are drawing from fungible factory capacity, or from the same small queue at the same packaging supplier. In AMD’s case, the queue matters more than the headline demand curve.
AMD’s Strongest Products Are Competing With Each Other
The supply-chain wrinkle is that AMD is not only scaling an AI GPU line. It is also scaling a server CPU franchise into the same advanced-packaging environment. The reported bind is straightforward: AMD must ration an estimated CoWoS allocation around EPYC Venice, its 2nm server CPU ramp, and MI400 GPUs. Every package slot consumed by one product family is not available to the other.[2]
That makes EPYC’s strength less like a separate bullish datapoint and more like part of the same allocation problem. IO Fund reported that AMD EPYC server CPUs are effectively sold out for 2026, with 30-plus week delivery windows and CPU price increases in the 10% to 35% quarter-over-quarter range, citing Reuters and The Elec. Yahoo Finance separately reported AMD supply strain tied to its growing role in global AI data centers.[3][4]
The price-increase range should not be read as uniform across every customer, configuration, or contract. It is a directional market signal. But it is the kind of signal procurement teams care about: extended delivery windows, tightening availability, and pricing behavior that implies buyers are no longer negotiating from a comfortable inventory position.
For AMD, that creates a less obvious internal decision. If MI400 demand is strong, the company wants to feed the AI accelerator ramp. If EPYC Venice demand is also strong, the company wants to protect a server CPU franchise that gives it platform relevance, customer stickiness, and data center wallet share beyond GPUs. The bind is not “CPU versus GPU” as a product-marketing debate. It is a packaging allocation decision with revenue, customer-priority, and delivery-date consequences.

Nvidia faces enormous CoWoS pressure too, but the shape of the problem is different. Its allocation pressure is primarily about scaling accelerator supply into overwhelming AI demand. AMD’s pressure includes that, plus a second high-value franchise pulling on the same packaging resource. That is why Nvidia’s larger estimated allocation does not simply mean it has an easier year. It means its constraint is not organized around the same internal CPU-versus-GPU tradeoff.
HBM Adds Another Queue, But CoWoS Still Sets The Frame
Advanced packaging is not the only scarce input in the AI supply chain. HBM3E is reported sold out for 2026, while HBM4 is ramping and SK Hynix holds about 62% share, according to Astute Group’s discussion of AMD and Nvidia Taiwan investment plans.[5]
That matters because an AI GPU shipment is not made deliverable by one solved constraint. A company can have a chip design, customer demand, and even some packaging allocation, then still face memory availability, qualification timing, or supplier-priority issues. In practice, procurement teams experience this as a stack of queues. The longest queue becomes the answer.
Still, CoWoS remains the central choke point for reading AMD’s 2026 upgrade cycle because it links both sides of the company’s data center story. HBM scarcity bears more directly on accelerators. EPYC availability points to CPU tightness. CoWoS is where the two stories collide.
Near-Term Revenue Models Are Running Ahead Of Medium-Term Capacity Relief
The timing issue is not that AMD lacks a capacity strategy. Astute Group reported that AMD’s Taiwan ecosystem investment exceeds $10 billion and targets capacity improvement in the 2027 to 2028 window.[5] That is meaningful if the question is whether AMD can become a more durable AI infrastructure supplier over multiple product cycles.
It is less comforting if the question is whether 2026 upside can be delivered smoothly. Analyst upgrades published after the Q1 print are pricing nearer-term revenue acceleration. Capacity additions that matter most in 2027 or 2028 do not automatically solve 2026 allocation. Procurement teams cannot buy against a future packaging expansion as if it were current supply.
This is where stock-market optimism can become a bad purchasing assumption. A Buy rating may be a reasonable view on earnings power, share gain, or customer mix. It is not a delivery commitment. For a buyer trying to lock server CPU availability, accelerator slots, or deployment timing, the relevant questions are more operational:
- Is the quoted lead time tied to standard availability, priority allocation, or a specific customer commitment?
- Does an EPYC order compete with MI400 capacity at the supplier-planning level?
- Are price increases reflecting broad scarcity, a configuration-specific shortage, or contract renegotiation?
- Which part of the delivery promise depends on CoWoS, and which part depends on HBM supply?
- Does the vendor’s 2027 capacity story change the buyer’s 2026 deployment risk, or only the next planning cycle?
What The Analysts Probably Saw
The upgrades are more interesting if they are treated as supply-chain intelligence rather than only equity research. Goldman saw a Q1 print strong enough to justify a more constructive stance. Bernstein connected agentic AI to server CPU demand, which is a better argument than simply extending the GPU boom to every adjacent semiconductor category.[1]
That agentic AI argument has legs because enterprise AI deployments are beginning to change planning and execution systems, not just demo environments. ChainSignal’s reporting on agentic AI planning risks and GE Aerospace’s agentic AI supply chain transformation shows why infrastructure demand cannot be reduced to model-training clusters alone. More autonomous planning systems still need conventional compute, orchestration, storage, networking, and governance layers.
But the upgrade case becomes less clean once those workloads turn into purchase orders. If EPYC delivery windows are already stretching past 30 weeks and CoWoS lead times are running at 52 to 78 weeks, then AMD’s execution risk is not only product competitiveness. It is sequencing. The company has to decide which customers receive scarce packaged silicon first, which products deserve priority, and how much future capacity it can credibly promise without creating a later shortfall.[2][3]
The Procurement Reading Of AMD’s Upgrade
For investors, the Goldman and Bernstein calls may prove right if AMD converts data center demand into revenue faster than the market expected. They may prove wrong if packaging, memory, customer prioritization, or execution frictions limit that conversion. That is the normal risk of a stock call.
For supply-chain teams, the more durable takeaway is narrower and more useful. AMD’s momentum is real enough to tighten markets around it. EPYC demand is not a side note to MI400 demand. HBM availability is not a footnote to GPU demand. CoWoS is not a generic foundry detail. Together they define how much of the bullish narrative can become deliverable supply in 2026.
The limiting question is therefore not only whether customers want AMD’s CPUs and AI GPUs. It is which product AMD can afford to package first.
References
- 5 big analyst AI moves: Wall Street hands AMD upgrades after strong Q1 print, Investing.com
- TSMC Foundry Allocation 2026: CoWoS Sold Out, 2nm Booked, ~1M Wafer Demand, Silicon Analysts
- AMD, Nvidia, Arm, Intel: Inside the $120 Billion CPU Gold Rush, IO Fund
- AMD Supply Strain Highlights Growing Role In Global AI Data Centers, Yahoo Finance
- AMD and Nvidia Taiwan Investment Plans Tighten AI Supply Chain Competition, Astute Group
