The AI Chip Boom Is Reshaping Semiconductor Supply Through 2028
Market AnalysisEditorially Independent

The AI Chip Boom Is Reshaping Semiconductor Supply Through 2028

The surging demand for AI chips is causing a structural reallocation of semiconductor production capacity, squeezing supply of conventional components used across electronics. This article explains why the shortage differs from earlier crises and outlines procurement strategies to manage constraints through 2028.

By Editorial Team

Primary sources: Accuris, Gartner, IndexBox, CNBC, Enki AI

The allocation update that matters in 2026 is not the one saying an AI accelerator is constrained. Everyone already knows that. The more uncomfortable update is the one where ordinary memory, power management parts, substrates, fiber optic components, and other “should have been routine” items start moving under the same priority logic as AI infrastructure. A buyer who thought they were outside the AI chip market can open a supplier note and discover they are still competing with it.

That is the practical meaning of AI chip market trends for supply chains in Q3 2026. The question is no longer whether AI demand is large. It is which planning assumptions break when conventional electronics buyers are no longer the most attractive home for capacity.

Accuris reports that AI data centers are expected to consume 70% of global memory chip output in 2026, leaving 30% for all other electronics, while semiconductor lead times reached 40 weeks as of March 2026 amid AI-driven demand for memory and fiber optic components. The same analysis says 30% to 50% of planned 2026 data center capacity is slipping to 2028 because of power and construction bottlenecks, which turns a capacity squeeze into a longer procurement cycle rather than a short spike to wait out. [1]

AI data center drawing most semiconductor component flows while smaller factories receive limited supply

This Is Not the 2021 Shortage With a New Label

The 2021–2023 shortage was ugly, but its mechanics were familiar: demand whipsaw, logistics disruption, factory interruptions, panic ordering, inventory distortion, and long recovery tails. Some products were genuinely short; others were trapped in the wrong place, double-ordered, or hidden behind bad visibility. Buyers spent too much time separating real demand from inflated backlog.

The 2026 cycle has a different center of gravity. The constraint is not only that semiconductor demand is high. It is that the industry has a better-margin place to put scarce engineering time, packaging capacity, memory output, advanced substrates, and supplier attention. Capacity follows margin. Strategic customers get protected. Everyone else gets a lead-time update and a discussion about flexibility.

The scale is not subtle. A Yahoo Finance article quoting Gartner senior principal analyst Rajeev Rajput reported that global semiconductor revenue is projected to reach $1.3 trillion in 2026, up 64% year over year, with AI chips alone at roughly $500 billion. The same article reported projected 2026 price increases of 125% for DRAM and 234% for NAND, with pricing relief not expected until late 2027. Those figures should be treated as Gartner figures reported through Yahoo Finance, not as a primary Gartner release available for direct inspection. [2]

For an OEM, the distinction matters because the fix is different. A pandemic-style shortage rewards careful backlog cleansing and inventory unwinding. A structural reallocation rewards early commitment, design flexibility, supplier segmentation, and executive escalation before the purchase order becomes a plea.

The Crowding-Out Mechanism

AI demand does not stop at the accelerator. A data center build pulls high-bandwidth memory, DRAM, NAND, advanced logic, substrates, power management, connectors, fiber optics, thermal materials, passives, and board-level capacity into one purchasing orbit. Some of those categories are technically specialized. Others look ordinary until the same supplier line, test cell, material input, or allocation committee has to choose between an AI customer and a conventional program.

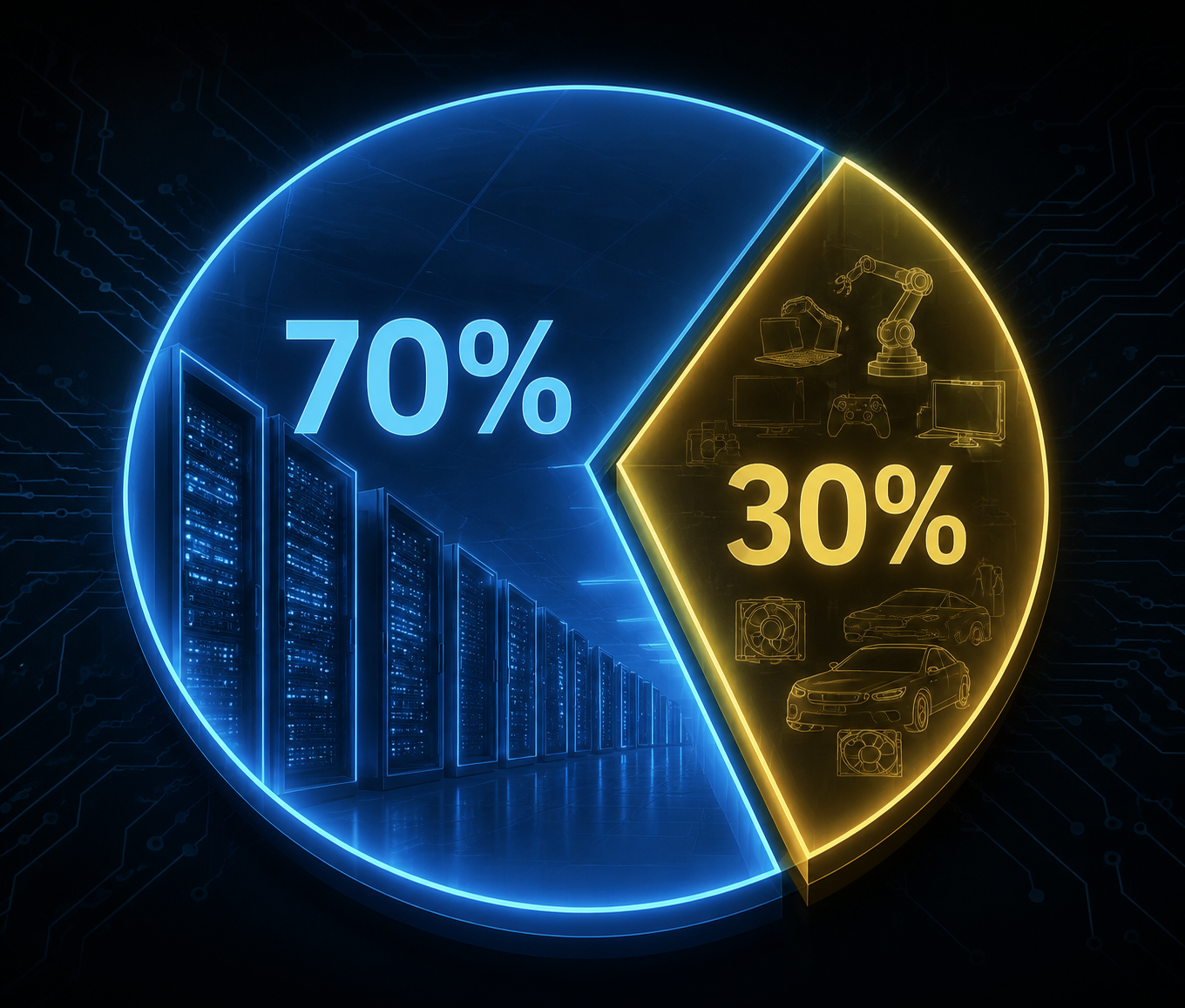

Datavis illustration showing 70 percent of memory chip allocation to AI data centers and 30 percent to other electronics

Memory is the cleanest example because the allocation split is visible. If AI data centers absorb 70% of global memory output in 2026, the other 30% has to cover industrial systems, automotive electronics, PCs, smartphones, networking gear, medical equipment, and every other product that still needs DRAM or NAND. That does not mean every memory part is equally constrained, but it does mean the non-AI buyer is working from a smaller effective pool. [1]

The same logic spreads into substrates. IndexBox, citing reporting around the substrate market, notes that Ajinomoto raised ABF substrate prices 30% in 2026 and that a supply gap exceeding 20% is projected for 2027. ABF is easy to ignore in a board review until it becomes the item that keeps advanced processors and networking silicon from shipping on schedule. [3]

Power ICs and fiber optics create a quieter version of the same problem. They are not always the headline constraint, but AI server racks raise demand for dense power delivery and high-speed interconnect. When lead times are already stretched, a shift in mix can produce shortages in parts that were never marketed as “AI chips.” That is how a glamorous demand cycle turns into a dull invoice problem for an industrial buyer.

Component poolWhat AI demand changesProcurement implication
MemoryAI data centers take a dominant share of 2026 outputNon-AI programs need earlier allocation commitments and price-escalation assumptions
Advanced logic and packagingHigh-margin AI devices absorb supplier focus and upstream capacityConventional programs need clearer strategic-account positioning
ABF substratesPrice pressure and a projected 2027 supply gap tighten availabilityBuyers should review package-dependent designs before release
Power management and passivesServer power density pulls adjacent component demand upwardApproved alternates matter before distributors quote extended lead times
Fiber opticsData center networking demand stretches lead timesNetworked products need earlier optical module and component planning

This is why the broad phrase “chip shortage” is not precise enough. The shortage behavior appears at category boundaries. A supplier may have capacity, but not for the part family, package, grade, or customer tier that a buyer assumed would remain available. A distributor may show stock, but not enough to support a production ramp. A second source may exist on paper, but qualification may be too late to protect the launch window.

Delayed Data Centers Do Not Remove the Demand

The most important detail in the Accuris data is not just the 2026 demand load. It is the slippage. If 30% to 50% of planned 2026 data center capacity moves to 2028 because power and construction cannot keep pace, semiconductor demand does not simply disappear. It queues. Buyers then face a longer period where hyperscaler orders, postponed builds, and new builds compete for overlapping components. [1]

That makes power availability and construction timing part of the semiconductor planning problem. A data center that cannot energize on schedule can still influence component reservations, supplier forecasts, and capacity planning. For buyers tracking the facility side of the constraint, ChainSignal’s coverage of the New York AI data center moratorium is useful because it shows how grid and permitting friction can feed back into already tight supply chains.

The buyer’s mistake would be to read delayed capacity as demand relief. In allocation markets, deferred demand can keep suppliers confident enough to hold price, protect strategic accounts, and ask weaker customers for better forecasts before committing capacity.

Why Conventional Buyers Lose Priority

Suppliers do not need to dislike conventional customers to deprioritize them. They only need a better alternative. Hyperscalers bring volume, visibility, willingness to fund capacity, and strategic importance. Accuris puts hyperscaler capital expenditure above $600 billion, a buying-power signal that most industrial, consumer, and mid-market electronics programs cannot match. [1]

Some investment figures deserve careful handling. Enki AI’s market-intelligence synthesis describes Nvidia investing $500 billion in the U.S. supply chain, but that figure is presented as an aggregation across multiple reported sources rather than a single independently verified procurement forecast. It is still relevant as a signal of the scale at which AI leaders are trying to secure domestic supply, but it should not be treated as a clean demand number for component planning. [4]

The operational result is familiar to anyone who has sat through an allocation call. The supplier asks for a longer forecast. The customer provides one. The supplier still wants a non-cancelable commitment, evidence of design lock, and a reason the account should matter. Meanwhile, the AI customer is discussing roadmaps, joint planning, and capacity reservation.

This is not a moral failure. It is an incentive structure. If a supplier can place scarce output into high-margin AI demand with better forecast visibility, conventional buyers need to bring more than quarterly purchase orders and a hope that the spot market calms down.

The Planning Assumptions That Break First

The first broken assumption is that a standard lead-time file is enough. A 40-week semiconductor lead time changes who owns the decision. By the time purchasing sees a routine shortage, engineering may already have released a design around a part family that cannot support the volume plan. Sales may already have committed a delivery window. Finance may still be using a material-cost baseline that belongs to a different market. [1]

The second broken assumption is that price inflation can be averaged across the bill of materials. DRAM and NAND projections of 125% and 234% price increases in 2026 are not normal commodity noise. Even if a buyer’s exact part numbers move less severely, the direction changes quote validity, customer pricing, margin protection, and inventory valuation. [2]

The third broken assumption is that alternates can wait until a constraint appears. In a structural reallocation cycle, the alternate supplier is often exposed to the same upstream inputs. A second-source strategy that shares the same substrate bottleneck, memory allocation pool, or packaging dependency is not the same as a true risk split.

The fourth broken assumption is that non-AI demand will be treated as stable base business. Stability helps, but it does not automatically create priority. A predictable low-margin customer can still lose to a volatile high-margin customer if the supplier believes the upside justifies the allocation.

Procurement Strategy Through 2028

The right response is not a blanket inventory build. That worked poorly in the last cycle and will work worse when constraints are uneven. The task is to identify where AI demand has changed the allocation hierarchy, then spend money and executive attention only where it improves access.

Commit in Multiple Horizons

A single 12-month forecast is too thin for categories pulled into AI infrastructure. Buyers need at least three views: firm near-term demand tied to purchase commitments, a mid-term scenario that reflects customer upside and downside, and a longer-range signal that helps suppliers justify capacity protection. The point is not to pretend the outer years are certain. The point is to show suppliers which programs are real, which volumes are optional, and where the OEM is willing to share risk.

For constrained memory, substrates, and fiber-linked components, procurement should know which forecasts are backed by customer orders, which are sales ambition, and which are engineering placeholders. Suppliers can smell padded demand. In a market where better customers are waiting, inflated forecasts reduce credibility faster than they create allocation.

Segment Suppliers by Allocation Leverage

Not every supplier relationship deserves the same treatment. Some suppliers control a true bottleneck. Some are distributors with limited influence over factory allocation. Some have alternatives in the approved vendor list but still depend on the same upstream material. A useful segmentation separates suppliers by constraint control, substitutability, revenue importance, and executive access.

Supplier positionWhat to ask forWhat not to waste time on
Controls scarce capacityCapacity reservation, roadmap review, escalation path, commitment termsWeekly expediting without a commercial decision
Distributor with limited factory pullInventory visibility, branch transfer options, NCNR exposure, customer priority rulesTreating quoted stock as secure supply
Qualified alternatePackage, substrate, test, and upstream dependency comparisonAssuming second source means independent risk
Non-critical commodity supplierPrice monitoring and service-level disciplineExecutive escalation before evidence of true constraint

Move Design-for-Availability Earlier

Engineering release is too late to discover that a preferred memory density, power IC package, optical component, or processor substrate path is sitting in the AI allocation stream. Design reviews need a supply-chain gate before release, not after the first missed delivery. The review should ask whether the part family shares capacity with AI servers, whether alternates are electrically and mechanically real, and whether the package or grade forces the program into a narrower supplier pool.

This is where technical bottleneck detail has value. Buyers do not need a seminar on advanced packaging, but they do need to know when a design choice creates exposure to a constrained packaging or substrate path. For more upstream detail, ChainSignal’s analysis of TSMC’s AI chip supply chain bottlenecks is a useful companion to the procurement view here.

Plan Price Escalation Before the Quote Expires

Memory pricing projections are severe enough that finance, sales, and procurement should not wait for supplier quotes to force the discussion. Should-cost models need scenario bands for constrained categories, not one annual inflation assumption spread evenly across the bill of materials. Customer contracts need escalation language where material volatility can break margin. Product managers need to know which SKUs become unattractive if memory or substrate costs move against them.

For teams building the pricing side of that response, ChainSignal’s piece on AI cost forecasting under structural inflation goes deeper into how to protect margin when cost baselines stop behaving like short-term exceptions.

Build Buffers Only Around True Constraints

The lazy answer is more inventory. The better answer is constraint-specific buffering. A constrained memory device with long qualification cycles may deserve a different safety-stock policy than a passive with broad alternates. A fiber optic component tied to data center demand may need earlier purchase coverage than a mechanical item with local supply. Inventory should protect the production plan, not decorate the balance sheet.

The buffer decision should include lead time, qualification time, demand certainty, price trajectory, obsolescence risk, and supplier allocation behavior. If a part is both constrained and design-locked, the inventory argument is stronger. If it is constrained but easy to redesign, engineering time may be the cheaper hedge.

Escalate the Parts That Used to Be Routine

Executive escalation is usually wasted when it becomes theater. It is useful when a routine component has become a shipment gate and the supplier needs a commercial reason to protect capacity. The escalation packet should be short: revenue at risk, customer commitments, qualified alternates, required allocation, decision deadline, and what the OEM is prepared to commit in return.

That last part matters. A request without a commitment is just another expediting email. If the OEM wants priority, it may need to offer forecast visibility, NCNR coverage, a capacity reservation, a longer agreement, or a roadmap connection that makes the account worth protecting.

Geopolitics Adds Risk, but It Is Not the Main Engine

Geopolitical shocks can amplify semiconductor constraints, especially when they touch energy, shipping, export controls, or critical manufacturing regions. CNBC’s May 2026 coverage of Iran-war risk discussed potential AI chip supply chain and cost exposure in that context. Those risks deserve scenario planning, but they are not the main explanation for the current component squeeze. [5]

The base case is already difficult without a new shock: AI infrastructure is pulling capacity toward high-margin demand, data center delays are extending the pressure window, and conventional buyers are being asked to prove why they deserve allocation. Geopolitical escalation would make that base case worse. It does not need to create it.

Teams building formal scenarios can use ChainSignal’s AI supply chain resilience planning for geopolitical escalation to separate structural allocation exposure from event-driven disruption risk.

What to Watch Through 2028

The next useful signals are not only semiconductor revenue forecasts. Procurement teams should watch whether memory allocation to AI data centers relaxes, whether DRAM and NAND pricing relief actually appears by late 2027, whether ABF substrate supply catches up with the projected 2027 gap, and whether delayed data center capacity lands in 2028 or slips again. Each signal changes a different planning assumption. None should be blended into a vague statement that “the market is improving.”

A buyer should also track supplier behavior more closely than supplier commentary. Are suppliers offering shorter quote validity? Are they asking for NCNR commitments on parts that used to move freely? Are distributors limiting order quantities? Are engineering teams being pushed toward newer packages because older capacity is no longer favored? Those are allocation signals before they become shortage headlines.

Through at least 2028, conventional component availability will depend less on whether the semiconductor industry “recovers” in aggregate and more on whether buyers adapt to a market where AI demand has changed who gets capacity first.

References

  1. AI Data Center Electronic Component Supply, Accuris, https://www.accuristech.com/blog/ai-data-center-electronic-component-supply/
  2. Gartner semiconductor forecast coverage, Yahoo Finance, April 9, 2026, https://finance.yahoo.com
  3. AI Growth Faces Four Major Supply Chain Bottlenecks, IndexBox, https://www.indexbox.io/blog/ai-growth-faces-four-major-supply-chain-bottlenecks/
  4. AI Chip Supply Chain Risk 2026, Enki AI, https://www.enkiai.com/ai-market-intelligence/ai-chip-supply-chain-risk-2026/
  5. Iran war AI chip supply chain costs, CNBC, May 19, 2026, https://www.cnbc.com/2026/05/19/iran-war-ai-chip-supply-chain-costs.html

Stay current with the AI supply chain field

New analysis, case studies, and vendor profile updates delivered to your inbox.

Subscribe to ChainSignal →

Comments

Join the discussion with an anonymous comment.

Loading comments...
Blogarama - Blog Directory
